Completed January 2026
Windows in Buda, TX
Plus Siding, Exterior Painting on the same job
We installed 21 replacement windows , then completed siding and exterior painting in Buda, TX. The work brought three exterior trades into one finished project.
- Trades
- Windows, Siding, Exterior Painting
- Location
- Buda, TX
- Completed
- Brands installed
- NT Windows, James Hardie, Sherwin Williams
Timeframe — Windows went in over two days in mid-November 2025. The final on-site window was January 5–8, 2026, for siding and painting.
Vendors and products — NT Windows Executive windows, James Hardie 12-inch Hardie Primed Smooth siding, and Sherwin Williams painting materials.
Outcome — The crew finished the combined exterior project on January 8, 2026.
Job APS-4574
Drag to Compare
Before & After


Scope of Work
What We Did
21 NT Windows Executive Replacement Windows · 12-Inch James Hardie Smooth Fiber Cement Siding with Exterior Painting
Windows
This Windows in Buda, TX project used NT Windows replacement windows. The scope included standard-size window installation and a technician's measurements. Closed-cell foam and exterior caulk were included to finish the openings. The window work was complete by January 8, 2026.
Learn more about our window replacement →Siding
This Siding in Buda, TX project used James Hardie 12-inch Hardie Primed Smooth fiber cement siding. Its primed surface suited a project that also included exterior painting. The smooth profile provided a consistent look across the siding work. The crew completed the exterior work on January 8, 2026.
Learn more about our siding replacement →Exterior Painting
Exterior Painting in Buda was part of this three-service project. Sherwin Williams supplied the painting portion. The project also used primed James Hardie siding and NT Windows replacements. The crew finished all on-site work by January 8, 2026.
Service price ranges are for that work before any discounts. Any total project cost mentioned on this page may include applied discounts.
Wondering where this lands on price? See what windows typically costs in Austin →
How It Went
The Journey
From the first phone call to the final walkthrough — what actually happened on this project.
First contact
June 24, 2025The homeowner found us through an online search and reached out on June 24, 2025. The conversation centered on replacement windows and siding for the Buda home.
Evaluation
June 24, 2025We inspected the home on June 24, 2025, and began the estimate that day. The planned work covered 21 replacement windows, James Hardie siding, and exterior painting. A window technician measurement was included to plan the replacement units.
Planning & approval
July 25, 2025The homeowner approved the project on July 25, 2025. We planned for NT Windows Executive replacement windows and 12-inch James Hardie Hardie Primed Smooth siding. The 21 windows were ordered on August 21.
Installation
The crew installed the windows over two days in mid-November 2025, using the specified foam and caulk as part of that work. We returned January 5–8, 2026, for the siding and exterior painting phase. That final visit ran across four on-site days, not one.
Completion
January 8, 2026The crew finished on-site work on January 8, 2026. By then, the Buda home had its 21 replacement windows, fiber cement siding, and exterior painting completed.

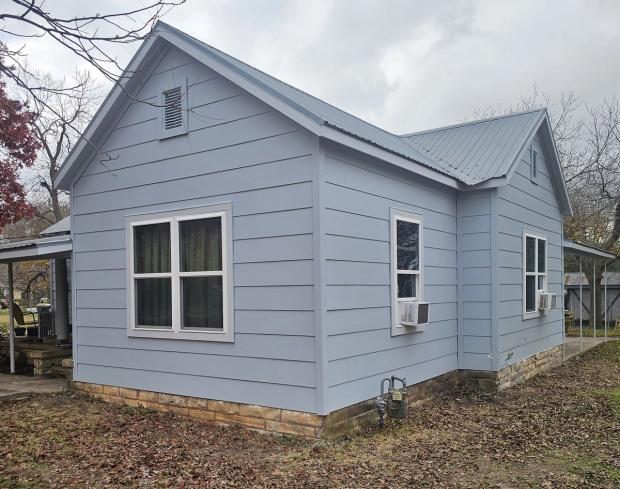

7 Photos
Project Photos
Every photo is this job, shot on site by our crew in Buda, TX.
Want this on your house?
The Full Story
Inside This Project
Why did this Buda project include both windows and siding?
The homeowner contacted us after an online search on June 24, 2025. We inspected the home that day and began planning the window and siding work together. That mattered because the window installation and the later exterior finish needed to make sense as parts of the same project.
A replacement window is not just a pane of glass. The crew also has to deal with the opening around it, where gaps need careful treatment before the work is finished. That is worth thinking through on a Buda home exposed to 100°+ summer days and seasonal cedar pollen. We did not need to invent a problem at every opening to make a plan; the scope already called for measurements, insulation foam, and caulk.
- The homeowner approved the project on July 25, 2025, before materials were ordered.
- The window scope covered 21 units rather than a single-room replacement.
- A window technician measurement was included ahead of installation.
- The later phase added fiber cement siding and a separate painting trade.
What shaped the choice of replacement windows?
We selected the Executive line from NT Windows for this 21-window job. The key planning step was to measure the openings before ordering, not assume every existing frame would match a standard size. The windows were ordered on August 21, 2025.
The installation scope also included labor for standard-size windows up to 132 united inches. That is a labor category, not a claim that every opening measured 132 inches. Homeowners can easily mistake a listed size limit for the dimensions of their own windows. Technician measurements are what turn a product selection into an installation plan for a particular house.
- The replacement units were installed over two days in mid-November.
- Closed-cell spray foam was included for the window installation.
- Foam cleaner appeared in the installation materials for that work.
- Sherwin-Williams Power House white caulk was specified for the window scope.
Why use primed fiber cement siding here?
The siding phase used James Hardie 12-inch Hardie Primed Smooth. Its smooth, primed surface fit the planned painting phase, so the exterior finish could follow the siding work. Fiber cement was also a sensible material choice for a Buda exterior that faces long, hot Central Texas summers.
“Primed” does not mean a siding board arrives as the final painted surface. For this project, exterior painting was part of the work after the siding installation. Keeping those steps together helped us plan the January visit as more than a siding drop-off.
- The siding material was fiber cement, not wood or vinyl.
- The specified board had a 12-inch profile and a smooth face.
- The painting work used Sherwin Williams materials; no paint color was specified for this spotlight.
- Siding and painting occupied the final four-day on-site window.
How did we sequence the work on site?
The windows went in first, during a two-day visit in November 2025. The crew returned January 5–8, 2026, for siding and painting. Those were separate installation periods, not one continuous job stretching from summer into winter.
That sequence gave each trade its own work window. Window installation called for fitting the replacement units and treating the gaps around them. The January crew then handled the siding and painted exterior surfaces. The final on-site day was January 8; the earlier contact and approval dates were planning time, not installation days.
- Delivery and installation materials were included in the window scope.
- Window labor covered fitting the replacement units at the home.
- The siding selection was made before the January exterior phase.
- The project included removal and disposal costs for the installation work.
What should a homeowner take from the finished project?
This Buda job shows why a combined exterior project needs a clear sequence. The homeowner could plan around a short window visit in November and a separate four-day siding and painting period in January. By the end of that second visit, all three services were complete.
It also shows the value of reading a material description closely. An Executive replacement window, a primed fiber cement board, and exterior paint each do a different job. None replaces careful measuring or a sound installation plan. That distinction matters whether your home is newly built or one of the many Central Texas houses updated after decades of heat and hail seasons.
- The project combined a primary window service with siding and exterior painting.
- The January finish date refers to the crew's last day on site.
- The work took place in Buda's 78610 ZIP code.
- The full project value fell in the $40,000–$50,000 range.
Straight Answers
Questions About This Project
Were the 21 windows installed during the January siding work?
No. The NT Windows units were installed over two days in mid-November 2025. January 5–8 covered the later siding and exterior painting visit.
Why measure replacement windows before ordering them?
The scope included a technician measurement before the 21 units were ordered. That step helps plan for the home's actual openings instead of treating an installation labor category as a window dimension.
Is primed James Hardie siding the same as finished paint?
No. This project specified primed, smooth fiber cement siding and a separate Sherwin Williams exterior painting service. Primer and the painted finish are different parts of the work.
Does “60-year” caulk mean the whole window installation has a 60-year warranty?
No. “60-year” is part of the specified Sherwin-Williams Power House white caulk description. It should not be read as a warranty for the 21 installed windows.
Get Your Free Windows Estimate
Tell us about your project — we'll call you back to schedule a free inspection. No pressure, honest numbers, 4.9 stars across 474 Google reviews.
Prefer to talk now? Call (512) 550-0000 · Mon–Fri 8–8, Sat 8–6, Sun 12–5
Keep Exploring
More Austin Pro Work
Windows
Windows
WindowsOther work near this address
0.5 mi away
0.8 mi awayAll highlighted Austin Pro projects → · Austin Pro in Buda → · Windows guides →
